New construction painting isn’t repainting with less prep. It is a different trade with a different sequence, a different pricing model, and a different definition of success.
On a repaint, the measure is how the finish looks and how long it lasts. On a build, the measure is whether the painter held the schedule. A painter who slips three days pushes flooring, which pushes trim-out, which pushes your certificate of occupancy and your closing date. That is the whole job.
Paint Gunners works with builders and general contractors across the Eastside, from custom homes in Sammamish to spec builds in Lynnwood to multi-family projects in Bothell. Here is how we approach new construction painting.

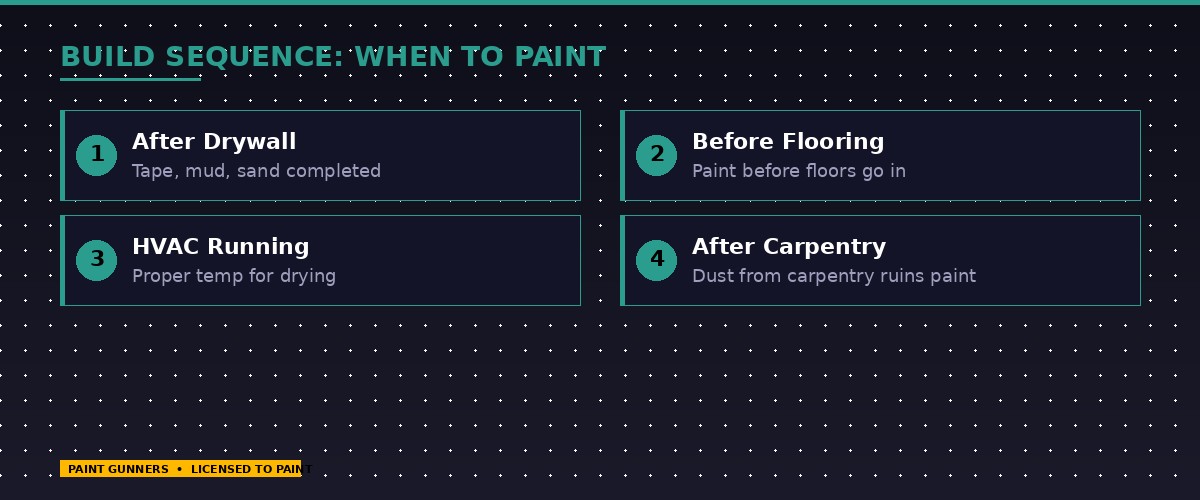

Paint Touches a Build Three Times
Confusion about which of these three phases a bid covers is the most common source of scope disputes we see on new construction. Get it stated explicitly and you avoid an argument later.
Phase one, texture and prime, after drywall. Drywall is hung, taped, and finished. Texture goes on to spec, then a full spray prime coat. That prime is as much a diagnostic as a finish. Primer reveals every drywall defect that was invisible on bare board, which is exactly when they can still be fixed cheaply.
Phase two, finish coats, after trim and before flooring. Walls and ceilings sprayed, trim and doors sprayed, interior brought to final appearance. Doing this before flooring goes in is what allows full spray application with minimal masking, and it is the main reason new construction interiors cost less per square foot than repaints.
Phase three, punch and touch-up, at the end. After every other trade has finished damaging the walls. This phase is not optional and it is not a favor. It is a scheduled, priced part of the job, and a builder whose painter treats it as an afterthought will feel that at final walkthrough.
Exterior runs on its own track, typically after siding and before final grade, subject to the May-through-October weather window that applies to everything outdoors in Western Washington.
Coordination Points That Actually Matter
You are typically five to six weeks from painting once drywall is hung. Three dependencies decide whether that holds:
Carpentry has to be done. Sawdust in the air lands in wet paint and there is no fixing it after the fact.
HVAC has to be operational. Not just installed. Cure conditions in a Puget Sound winter depend on it, and paint applied in a cold, unconditioned shell will not perform the way the data sheet promises.
Lighting has to be roughed in. A crew cannot produce a clean finish in a space they cannot properly see.
We state our dependencies in writing at contract, which is what prevents the conversation where the painter and the drywaller each blame the other for a lost week.
The Process, Step by Step
Prime coat. Full spray PVA primer on all new drywall. It seals a porous surface so the finish coat absorbs evenly, and it exposes defects in the drywall finish.
Defect reporting. Every blemish the primer reveals goes back to your drywall contractor immediately rather than getting buried under two finish coats and surfacing at the buyer walkthrough. This single habit prevents more callbacks than anything else we do.
Touch-up sanding. Nail pops, rough spots, and raised areas sanded flush once primer is dry.
Trim, doors, and casing. Primed and sprayed for a factory finish. This is the phase where sprayed new construction visibly beats a repaint, because trim gets finished before flooring and without masking. Waterborne alkyd enamel is our default. It levels like oil, cures hard, and does not yellow.
Finish coats. Two coats on walls and ceilings, sprayed. Ceilings get dead-flat, because any sheen telegraphs drywall seams under the raking light of a new build.
Exterior. Full prep on bare wood, and priming of every cut edge. That includes the field cuts your siding installer made on site, which is where new construction exteriors most often fail early. Then caulking of all joints and penetrations, and two coats of premium exterior acrylic.
Punch and closeout. Room-by-room walk with your superintendent, touch-ups on the spot, then a color and product schedule by room and surface for the homeowner packet, so your warranty department can match a touch-up two years out without guessing.
Four Problems and How We Avoid Them
Flashing. Uneven sheen where drywall patches absorb paint differently than the surrounding board. Fix: a genuine full prime coat, not spot priming with a promise the finish will even out.
Trade damage. Electricians, plumbers, and HVAC crews nick fresh walls during finish work. Fix: schedule the final coat after all other trades complete. This is a sequencing decision, not a painting decision, and it belongs in the schedule from day one.
Color inconsistency. Different paint batches vary slightly, and on a large wall that variation is visible. Fix: box the paint, mixing batches together, before starting.
Texture drift across units. On multi-family, buyers tour several units and notice when one reads differently. Fix: match texture spec across the whole phase and document it. Builders underestimate this one consistently.
New Construction Painting Costs (Eastside 2026)
| Scope | Typical range |
|---|---|
| Standard new construction, per sq ft of living space | $2.50 – $5.00 |
| Custom home with extensive trim | $4.00 – $7.00 |
| Interior only, 2,000–2,500 sq ft home | $4,500 – $8,000 |
| Complete interior and exterior | $8,000 – $20,000 |
| Multi-family, per unit | $2,500 – $5,500 |
| Typical 2,500 sq ft Eastside home | $6,000 – $12,000 |
Ranges include full prime, two-coat walls, two-coat trim, and a scheduled touch-up walkthrough.
What moves the number: ceiling height and volume, because staging is the real cost on tall interiors. Trim package, where a craftsman package with wainscoting and coffered ceilings is an enormous spread over ranch casing at the same square footage. Texture spec, since level 5 smooth requires substantially more drywall finishing. And schedule compression, because if upstream trades have eaten your float and our window is now four days instead of eight, that costs more. We would rather price that honestly than agree and then miss.
Why New Construction Prices Below a Repaint
An empty house can be sprayed. No furniture to move, no masking of finished surfaces, no daily setup and teardown, no wall repair, no color-change coverage problem. A crew covers several times the square footage per day.
What you pay for instead is coordination. On production and multi-unit work, that coordination is most of what you are actually buying. If you are also handling occupied buildings or ongoing turns, our commercial painting service runs on the same model at a different scale, and the first repaint cycle on delivered homes lands about eight to ten years out under exterior painting.
Building on the Eastside? Contact Paint Gunners for new construction painting or call (206) 930-8885. Send plans and specifications and we will return a line-itemed bid broken out by phase, usually within five business days.
